CTA closes Loop 'L' tracks for weekend repairs amid State/Lake rebuild

CTA closes Loop 'L' tracks for weekend repairs amid State/Lake rebuild

Built World Chicago, IL local

Loop tracks were due back early Monday, but Green and Pink Line riders now wait past the Oct. 28 target, with no exact return time.

Overview

Updated Oct 29

The Loop elevated tracks closed from Saturday until early Monday while the CTA finished track and interlocking work at Tower 18, the Loop and Lake junction at Wells and Lake. Brown, Green, Orange and Pink trains stayed out of downtown, with shuttle buses filling the gaps. The CTA said the Tower 18 work finished on schedule.

The Chicago Department of Transportation (CDOT) pushed Green and Pink Line service across the Lake Street Bridge from Monday to 4 a.m. Wednesday, Oct. 28, citing complex alignment problems. On Oct. 27 it said service would not return Wednesday morning and is now expected later this week, with no exact time. Green Line trains still split at Clinton and Clark/Lake, and Pink Line trains still end at Racine.

Why it matters

Four 'L' lines lose downtown for a weekend, and two of them stay cut off from the Loop for two extra days.

Last Monday's email for Chicago, IL

Sent Nov 9. It carried:

Get next Monday's: one short email a week. Free. Unsubscribe in one click.

Questions about this story

Free account needed to ask — your question is kept and asked for you right after sign-up. Answers are public.

No questions yet — be the first to ask.

Key Indicators

4
Loop lines affected this weekend
Brown, Green, Orange and Pink line trains are kept out of the Loop.
46 hrs
Loop closure length
4 a.m. Saturday to 2 a.m. Monday, per CTA's service alert.
No date
Green and Pink Line return
The Oct. 28 target passed. CTA says service is expected later this week, with no exact time.
1895
Year State/Lake station opened
The station closed in January 2026 for a rebuild into 2029.
2029
State/Lake rebuild completion target
CTA says the station is closed for reconstruction into 2029.

Voices

Curated perspectives — historical figures and your fellow readers.

Sign up to generate historical perspectives on this story.

Organizations Involved

Timeline

1895 October 2026

9 events Latest: October 27th, 2026 · 2 weeks ago
Tap a bar to jump to that date
  1. Green and Pink Line return pushed past Oct. 28

    Latest Announcement

    CDOT said Green and Pink Line trains will not resume across the Lake Street Bridge on Wednesday morning. CTA now expects normal service later this week, with no exact time.

  2. Green and Pink Line disruption extended to Oct. 28

    Announcement

    CDOT said Green and Pink Line service across the Lake Street Bridge will resume at 4 a.m. Wednesday, Oct. 28, two days later than planned, while CTA finished the Tower 18 interlocking work and kept the Loop reopening on schedule.

  3. Loop 'L' track closure begins

    Service disruption

    All Loop elevated tracks are scheduled to close at 4 a.m. Saturday and reopen at 2 a.m. Monday for Loop and Lake Junction repairs.

  4. CTA announces Loop and Lake Junction closure

    Announcement

    CTA says all Loop elevated tracks will close from 4 a.m. Saturday, Oct. 24, to 2 a.m. Monday, Oct. 26.

  5. Lake Street Bridge replacement interrupts Green and Pink Line service

    Construction

    CDOT's bridge work cuts the Clinton–Clark/Lake link through Oct. 26, a window CTA is using to reach the remaining Loop and Lake Junction quadrants.

  6. Second State/Lake weekend closure

    Service disruption

    Same stations and lines affected for additional track and steel repairs.

  7. First State/Lake weekend closure

    Service disruption

    Loop stations close; Green, Brown, Orange and Pink lines rerouted for track work.

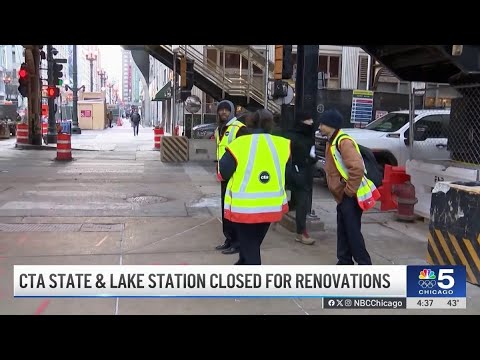

  8. State/Lake station closes for reconstruction

    Construction

    The 1895 station shut down for a rebuild that CTA says will last into 2029.

  9. State/Lake station opens

    Construction

    The elevated station opens as part of Chicago's Loop 'L'.

Scenarios

1

New State/Lake station opens on schedule in 2029

Likely Resolves by End of 2029

Discussed by: CDOT and CTA project documents; the July advisory states construction is expected to complete in 2029.

Construction proceeds on the current schedule. Weekend closures continue through 2028 as crews rebuild the track structure and station. The new State/Lake opens with elevators, wider platforms, and the glass canopy by late 2029.

2

State/Lake rebuild delayed past 2030

Possible Resolves by End of 2029

Discussed by: No city forecast of a delay; included because large transit projects commonly run late.

Unforeseen conditions slow the work. Steel in the 130-year-old structure turns out worse than expected, or supply and funding issues push the schedule. CDOT revises the completion date to 2030 or later, and riders face additional closures.

3

Structural issues force extended Loop shutdown

Unlikely Resolves by End of 2027

Discussed by: CDOT's own advisory notes crews are performing 'existing steel repairs,' signaling the structure needs ongoing attention.

Inspections during reconstruction reveal deterioration serious enough that weekend work won't cut it. CTA announces a longer closing, several weeks or a full segment, to replace major steel. That would mean bus bridges and major reroutes for Loop riders.

4

Green and Pink Line service slips past Oct. 28

Deadline passed (Oct 28, 2026)

Discussed by: No agency forecast of a further delay; included because the Oct. 26 target already moved once.

Alignment checks or signal testing on the new bridge leaf turn up a problem, and CDOT pushes the return date again. Green Line riders keep shuttling between Clinton and Clark/Lake, and Pink Line riders keep transferring to the Blue Line at Racine.

5

Green and Pink Line service returns across the Lake Street Bridge by Oct. 31

Deadline passed (Oct 31, 2026)

Discussed by: CTA, citing CDOT's schedule

CTA says normal Green and Pink Line service is expected later this week. A return by Friday, Oct. 30 or Saturday, Oct. 31 would match that timing. Slippage past that would mean a further delay.

Historical Context

3 moments from history that rhyme with this story — and how they unfolded.

May–October 2013

CTA Red Line South reconstruction (2013)

CTA closed the Red Line's South branch for five months in 2013, a $425 million project to replace worn track and rebuild stations. Shuttle buses carried riders between Cermak-Chinatown and 95th Street for 21 weeks.

Then

The line reopened in October 2013 with new track, rebuilt stations, and faster trains.

Now

The success gave CTA a template for long, planned closures, showing that big shutdowns can be managed.

Why this matters now

State/Lake's weekend-by-weekend approach is the opposite strategy: keep the system running, do the work in short bursts. Both are ways to renew a century-old system.

August–September 2022

Boston MBTA Orange Line 30-day shutdown (2022)

Boston closed its entire Orange Line for 30 days in August 2022 to replace track, signals, and fix years of deferred maintenance. About 100,000 daily riders were moved to shuttle buses.

Then

Crews replaced miles of track and overhauled signals in one month, work that weekend closures would have stretched for years.

Now

The closure became a national example of the trade-off between long disruption and long-term reliability.

Why this matters now

Chicago's 48-hour closures fix smaller pieces of the same problem: an old elevated structure that can't be fully renewed in a single weekend.

2009–2020s

Toronto Union Station revitalization (2009–2020s)

Toronto spent more than a decade rebuilding its 1927 Union Station while keeping it open, renewing platforms, concourses, and the historic train shed in phases.

Then

Commuters put up with years of detours, crowding, and closed sections.

Now

The station ended up modernized and accessible, with its heritage exterior preserved.

Why this matters now

State/Lake uses the same playbook: keep the station's identity, rebuild it in phases, and accept years of disruption before the modern version opens.
