Ferrovial-led group wins I-285 express lanes contract in Georgia

Ferrovial-led group wins I-285 express lanes contract in Georgia

Built World

Consortium pays Georgia $23.6B for a 50-year toll deal, and analysts are questioning the returns

Overview

Updated Oct 20

Georgia's State Transportation Board picked the Ferrovial-led Top End Mobility Group on October 15 to build and run toll lanes along the top of I-285, an $8.9 billion construction job in exchange for 50 years of toll revenue. The consortium also offered a $23.6 billion concession fee plus $515 million in reimbursements, and its bid scored 1,944 points out of 2,500 in the state's evaluation, against 1,084 for Sacyr's team and 482 for the ACS and Acciona group.

Investors are wary of the price. Ferrovial shares are down about 3.5% since the award, against a 1% fall for Spain's Ibex, and down 21% this year. Kepler put the project's expected return at 8% to 15%, weaker than Ferrovial's earlier deals, while Jefferies estimated the company's capital needs at $14 billion to $19 billion against roughly $12 billion of cumulative free cash flow through 2034.

Why it matters

Georgia shifts the financial risk of an $8.9 billion highway rebuild from taxpayers to private investors, in exchange for 50 years of toll revenue on Atlanta's most congested corridor.

Questions about this story

Free account needed to ask — your question is kept and asked for you right after sign-up. Answers are public.

No questions yet — be the first to ask.

Key Indicators

8–15%
Expected project return (Kepler)
Kepler's estimate for the I-285 concession, which it says is weaker than Ferrovial's earlier projects; Jefferies puts Ferrovial's combined capital needs at $14 billion to $19 billion.

Voices

Curated perspectives — historical figures and your fellow readers.

Sign up to generate historical perspectives on this story.

People Involved

Organizations Involved

Timeline

3 events Latest: October 16th, 2026 · 4 weeks ago
  1. Ferrovial confirms $8.9B express lanes award

    Latest Announcement

    Ferrovial announces its consortium won the I-285 East Express Lanes Phase 1, its first managed lanes project in Georgia.

  2. State board approves Top End Mobility Group for I-285

    Decision

    Georgia State Transportation Board selects the Ferrovial-led group as Phase 1 developer, beating two other applicants.

  3. Ferrovial shares slide as analysts question I-285 returns

    Market reaction

    Ferrovial stock falls about 3.5% after the award, against a 1% drop for Spain's Ibex. Kepler puts the project's expected return at 8% to 15%; Jefferies estimates Ferrovial's capital needs at $14 billion to $19 billion against about $12 billion of free cash flow through 2034.

Scenarios

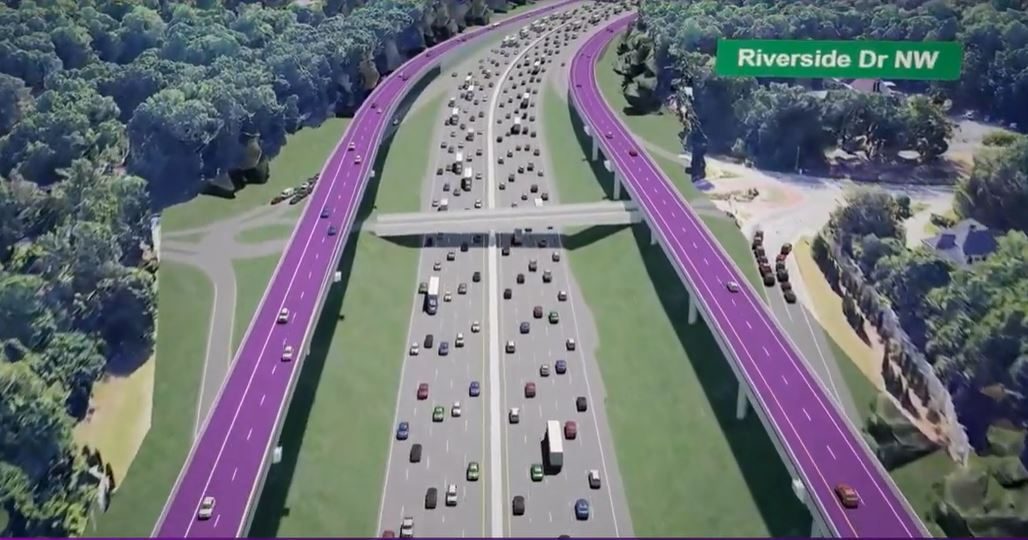

1

Top End Mobility Group closes Phase 1 deal by December 2026

Likely Resolves by End of 2026

Discussed by: GDOT and Ferrovial, both of which stated the expected close date

GDOT says commercial close, including signing of agreements for Phase 1 and the remaining phases, is anticipated in December 2026, with financial close in 2027. If financing holds through the payment structure for the $23.6 billion concession fee, construction starts late 2027 and Phase 1 opens around 2034.

2

Financing pressure forces deal renegotiation before financial close

Unlikely Resolves by Q2 2027

Discussed by: Infrastructure finance press covering the P3's unprecedented scale

The $23.6 billion concession fee has no close precedent in U.S. highway P3s, and financial close is set for 2027. If credit markets tighten or the consortium cannot raise debt for the $8.9 billion build, the fee or project scope could be renegotiated to keep the deal viable.

3

Construction start slips past late 2027

Possible Resolves by End of 2027

Discussed by: AJC, which noted years of construction disruptions ahead for drivers

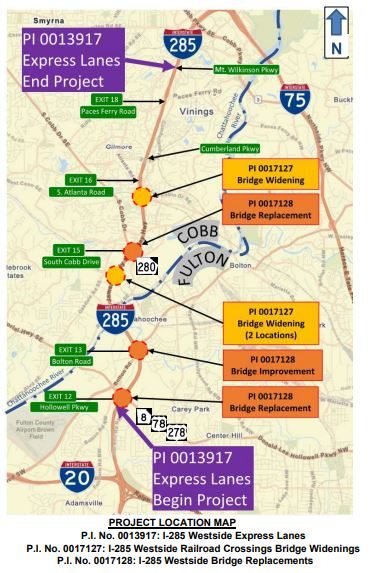

GDOT targets construction start in late 2027 and Phase 1 substantial completion in 2034. Permitting, utility relocation, and environmental review across roughly 20 miles of a live highway could push the start date, delaying the 2034 opening and extending the disruption window for commuters.

4

Record concession fee pushes tolls higher or trims returns

Possible Resolves by End of 2034

Discussed by: Reason Foundation's Robert Poole and UBS analysts, quoted by Bond Buyer

The $23.6 billion fee is about six times the prior U.S. record, the $3.8 billion fee in Georgia's SR-400 project. Poole warns such fees translate into higher tolls or lower developer profits. UBS analysts, after Ferrovial's Tennessee bid, called the big offers a question mark on value creation and an overhang on the stock. ACS Infrastructure CEO Steven DeWitt counters that fees reflect 50-year traffic demand and operating gains.

5

Ferrovial takes a hit or reworks terms as I-285 returns lag

Possible Resolves by Oct 31, 2027

Discussed by: Kepler and Jefferies analysts

Kepler estimates the project will return 8% to 15%, less than Ferrovial's earlier concessions, and says the absence of Transurban from the consortium may mean a bigger equity contribution from Ferrovial. Jefferies sees capital needs of $14 billion to $19 billion against about $12 billion of free cash flow through 2034, leaving little room for cost overruns. If construction costs or interest rates rise before the October 2027 financial close, returns could fall further.

Historical Context

3 moments from history that rhyme with this story — and how they unfolded.

As of 2026

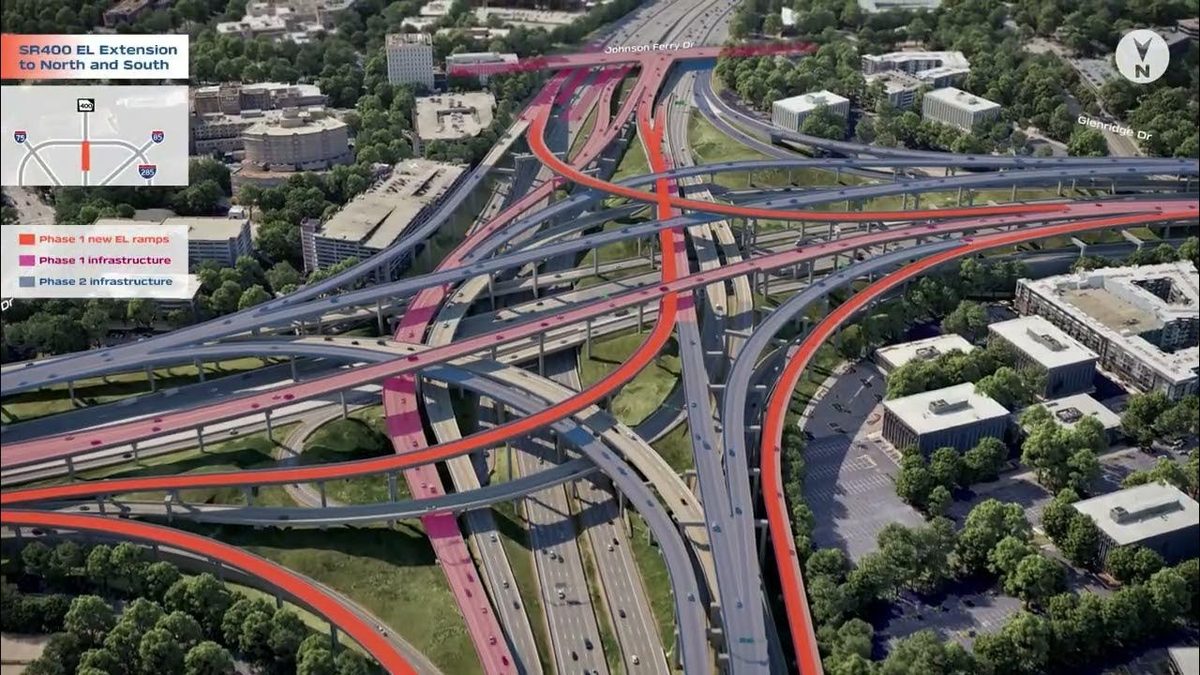

SR 400 Express Lanes P3 (ongoing as of 2026)

Georgia is applying the same public-private partnership model on State Route 400 north of Atlanta, where a consortium is building tolled express lanes currently under construction, per GDOT. The state uses the model for roads where private financing and toll revenue replace public funds.

Then

SR 400 is Georgia's working precedent for private construction and operation of express lanes on a major corridor.

Now

It establishes the legal and financial template the I-285 award copies, including dynamic tolling and the Peach Pass system.

Why this matters now

I-285 follows the SR 400 structure almost exactly, with a private developer building, financing, and operating the lanes for decades in exchange for toll revenue.

2000s-2020s

Georgia express lanes network (15+ years, four systems)

Georgia's Express Lanes program has grown to four operating systems on I-85 north of Atlanta, I-75 south, and I-75 and I-575 in the northwest, using the Peach Pass transponder. GDOT says the goal is an uninterrupted network of toll lanes around metro Atlanta.

Then

The existing lanes already give drivers a paid option to bypass congestion on several corridors.

Now

I-285 is the missing eastern link that would complete the express-lane loop around the region.

Why this matters now

The I-285 award is the largest single step toward finishing that network, and it connects to SR 400 and I-85 lanes already operating or under construction.

2010s-2020s

Ferrovial's U.S. managed lane portfolio (Dallas, Charlotte, Washington D.C.)

Ferrovial has delivered and operated express lanes in Dallas Fort Worth, Charlotte, and Washington, D.C., the company says. Those projects used the same concession model I-285 uses, with toll revenue repaying the private investment over a long term.

Then

Ferrovial gained operating experience with dynamic tolling and lane management across multiple U.S. markets.

Now

Georgia becomes Ferrovial's fourth U.S. managed-lane market, extending its North American highway footprint.

Why this matters now

That track record underpins the consortium's ability to bid on a project of I-285's size and to operate the lanes profitably for 50 years.
