DP World installs new harbor cranes in $800M modernization of Syria's Tartus port

DP World installs new harbor cranes in $800M modernization of Syria's Tartus port

Built World

First payoff of a 30-year, $800 million concession to rebuild Syria's Mediterranean port of Tartus after civil war

Yesterday: Installation milestone reported

Overview

Updated 16 hours ago

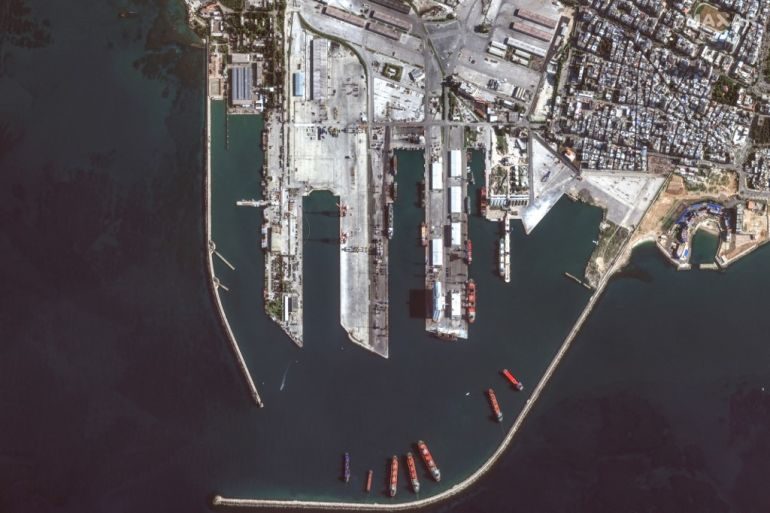

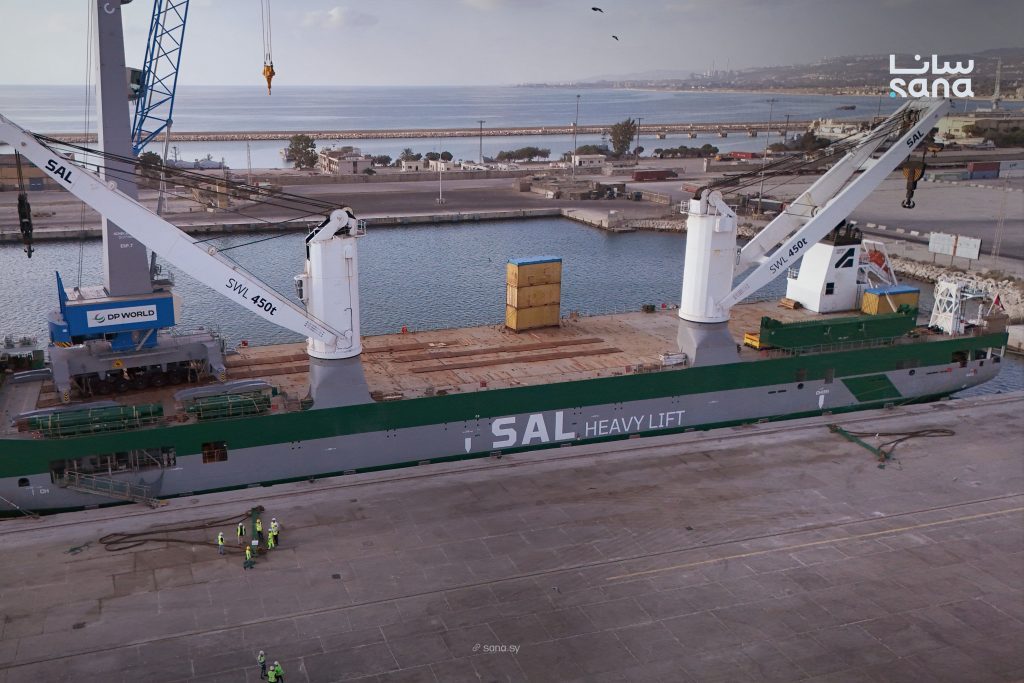

Three mobile harbor cranes now work Syria's Mediterranean port of Tartus. They are the first visible payoff of Dubai-based DP World's $800 million plan to rebuild a port wrecked by 13 years of civil war.

The cranes can raise cargo capacity by about 40%, and commercial control of the port has passed from Russian to Gulf hands. An independent maritime monitoring group, IMWO, says the harder work (dredging, berth depths, quay repairs) has not been publicly verified. The real test is whether cargo shows up.

Why it matters

DP World's $800 million rebuild will decide whether Tartus becomes Syria's trade lifeline and regional transit hub, or a costly bet that found no cargo.

Questions about this story

Free account needed to ask — your question is kept and asked for you right after sign-up. Answers are public.

No questions yet — be the first to ask.

Key Indicators

$800M
Investment planned under 30-year Tartus concession
Total committed by DP World over the life of the build-operate-transfer deal.
40%
Expected increase in port cargo-handling capacity
DP World's estimate once the three mobile harbor cranes are fully operational.
3
Mobile harbor cranes delivered and installed
Each crane can handle about 2 million tonnes of cargo per year.

Voices

Curated perspectives — historical figures and your fellow readers.

Ever wondered what historical figures would say about today's headlines?

Sign up to generate historical perspectives on this story.

Play

Exploring all sides of a story is often best achieved with Play.

Most of these play right now — no account needed. Sign up to save scores, keep a streak, and unlock Debate and Predict. Log in Sign Up
Predict 4 ways this could play out. Back the one you believe — contrarian picks score more when a scenario has a resolution date. Log in to play

People Involved

Organizations Involved

Timeline

January 2019 September 2026

8 events Latest: Yesterday
Tap a bar to jump to that date
  1. Installation milestone reported

    Latest Milestone

    Engineering News-Record reports the cranes are being installed, marking progress under the $800 million program.

  2. DP World completes delivery of three cranes

    Equipment

    All three mobile harbor cranes delivered, expected to raise cargo capacity about 40%.

  3. First mobile harbor crane arrives at Tartus

    Equipment

    The first of three mobile harbor cranes arrives, each capable of handling about 2 million tonnes of cargo a year.

  4. DP World takes over Tartus operations

    Operations

    Formal handover from Syria's port authority; DP World begins assessing infrastructure and plans dredging.

  5. Syria awards Tartus to DP World

    Contract

    DP World signs a 30-year build-operate-transfer concession on July 13, 2025, committing $800 million to rebuild the port.

  6. Syria cancels Stroytransgaz Tartus contract

    Contract

    Syria's new authorities scrap the Russian firm's 49-year deal, citing failure to meet its terms.

  7. Assad falls, Syria's civil war ends

    Conflict

    After a war that began in March 2011, the Assad government collapses and a new administration takes over Syria.

  8. Stroytransgaz wins 49-year Tartus commercial contract

    Contract

    Russian firm Stroytransgaz takes a 49-year deal to manage Tartus commercial operations, deepening Moscow's grip on the port.

Scenarios

1

DP World meets its 2027-28 equipment and dredging schedule

Likely Resolves by End of 2028

Discussed by: DP World's own announcements, Engineering News-Record

DP World delivers the nine additional light-duty mobile harbor cranes through 2027 and early 2028, the new quay crane in 2028, and completes quay wall refurbishment by the end of 2027 as scheduled. The port deepens with dredging and grows into its expanded capacity.

2

Sanctions or renewed conflict slows the rebuild

Possible Resolves by End of 2027

Discussed by: Radio Free Syria, reporting on sanctions lifting and security

The lifting of most international sanctions is what enabled DP World's investment. If sanctions return, or if security in the region deteriorates, equipment deliveries, dredging and quay work could stall and the $800 million program could stretch far beyond its schedule.

3

Port rebuilt but underused as Syria's economy lags

Possible Resolves by End of 2028

Discussed by: Assessments of Syria's slow economic recovery

New cranes and deeper berths only matter if cargo shows up. If Syria's broader reconstruction stalls and imports and transit trade stay weak, Tartus could sit with equipment running well below capacity, making the $800 million hard to justify commercially.

4

Dredging falls behind the equipment schedule

Possible Resolves by End of 2027

Discussed by: IMWO, an independent maritime monitoring group

DP World has delivered the cranes and a harbor tug. But an IMWO brief says no evidence of dredging, berth depths or quay readiness has been published. If dredging lags the equipment schedule, the new cranes lift no more cargo than before, because larger vessels still cannot reach the berths.

Historical Context

3 moments from history that rhyme with this story — and how they unfolded.

1971 - present

Russia's Tartus naval base (1971-present)

The Soviet Union secured a naval maintenance facility at Tartus in 1971, which Russia kept as its only Mediterranean resupply point. In 2019, Russia's Stroytransgaz added a 49-year commercial contract to run the port's money-making side.

Then

Syria's new authorities cancelled the commercial contract in January 2025 and gave the port to DP World.

Now

Russia keeps a restricted naval section, but its commercial grip on the port is gone.

Why this matters now

The DP World concession is a direct reversal of Russian commercial control at the port Moscow once used as its Mediterranean anchor.

2003 - 2015

Iraq's Umm Qasr after 2003

After the 2003 invasion, Iraq's main port, Umm Qasr, was a priority for reconstruction so aid and imports could flow. Initial repairs restored basic operations, but full modernization dragged on for years amid security problems and funding gaps.

Then

The port resumed working quickly but remained a bottleneck for Iraqi imports.

Now

It took over a decade and repeated investment rounds to meaningfully expand capacity.

Why this matters now

Tartus faces the same basic challenge: new cranes help, but rebuilding a working port system takes years of dredging, equipment, and steady demand.

May 2009 - February 2018

Djibouti's Doraleh terminal (2009-2018)

DP World built and ran a container terminal in Djibouti under a long-term concession. In 2018, Djibouti seized the facility, arguing the contract was unfair, and forced DP World out.

Then

DP World was locked out and took the dispute to international arbitration.

Now

The seizure became a reference point for political risk in port concessions across Africa and the Middle East.

Why this matters now

The same operator now holds a 30-year Tartus concession in a country emerging from civil war. The Djibouti case shows how fast a sovereign can pull a port back.
